    Campus Plan



    Campus Plan Open House

    Thank you to the more than 300 participants who participated in the Open House Vision and Priorities session held Wednesday, Oct. 8. We will share a complete report of our findings in November 2025.

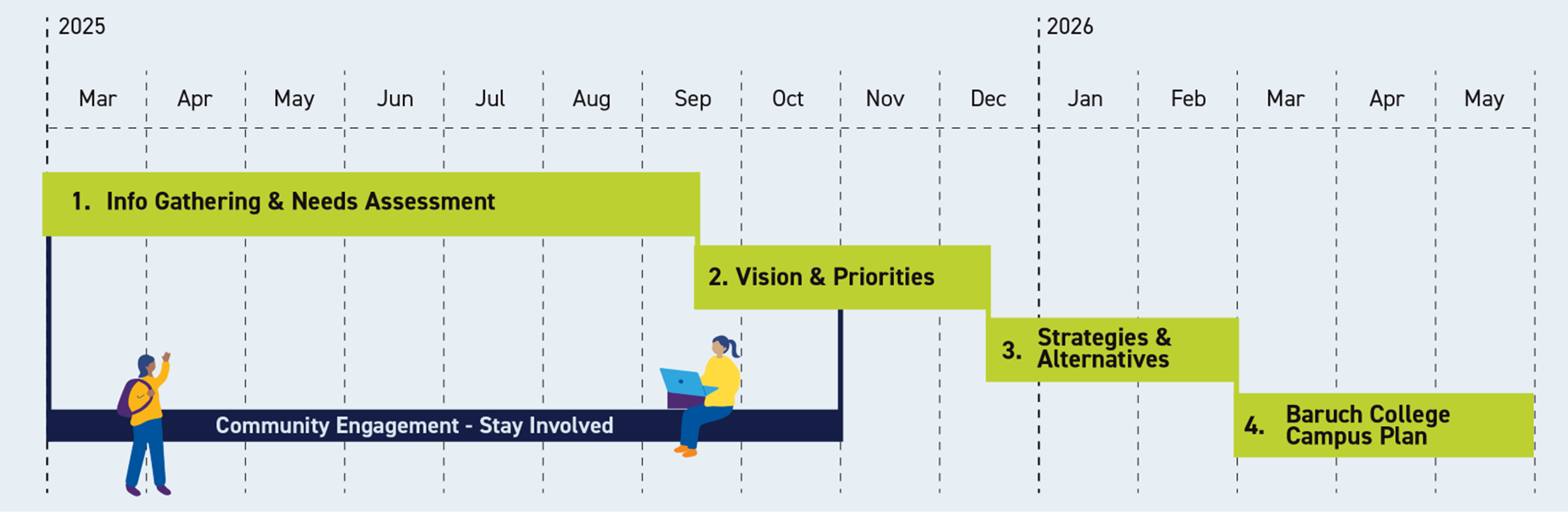

    Project Timeline

    The campus plan creation process will be conducted in four phases:

    • Information Gathering and Needs Assessment Spring–Summer 2025
    • Vision and Priorities Fall–Winter 2025
    • Strategies and Alternatives Winter 2025–Spring 2026
    • Baruch College Campus Plan Spring–Summer 2026



    What We’ve Been Up To

    April:

    • Steering Committee Meeting: Translate the campus plan’s guiding principles into physical realities and present transformative “big ideas” for the entire college. Highlight strategic opportunities to optimize space and enhance the Baruch District’s overall connectivity and identity.

    January–March:

    • Steering Committee Meeting: Strategic vision to create a more connected, efficient, and innovative campus by optimizing classroom space alignment and urban design; key recommendations shaped.

    December–January:

    • Strategies and Alternative Phase of the project begins and the campus planning team is now looking at specific options for campus.

    November–December:

    • Guiding Principles Defined: Presentation of Guiding Principals that are established through technical building assessments, space-utilization data, and community input.
    • Steering Committee Meeting: Summary of space needs; emerging strategic drivers of the campus plan.
    • Summary Report for the Vision and Campus Priorities: Read the full report here.

    October:

    • Steering Committee meeting: Summary of Campus Planning Team learnings to date; engagement and guiding principles updates.
    • Two small discussion groups (one for faculty, one for students) held to discuss topics related to Vision and Campus Priorities.
    • On-campus Open House: More than 300 community members shared feedback and opinions on the identified Vision and Campus Priorities. Full summary report available in November 2025.

    September–October:

    • Campus Wide Online Survey: Provided an opportunity for students, faculty, and staff to respond to ideas presented in the Vision and Campus Priorities phase.

    August:

    • Steering Committee Meeting: Shared program interview findings and office utilization plans.

    June–July:

    • Program and Stakeholder Interviews: Spoke with representatives from different campus units, including operations, administration, student affairs, and academic departments

    June:

    • Steering Committee Meeting: Shared assessments of existing conditions, including physical infrastructure, space use analysis, and classroom usage

    May:

    • Steering Committee Meeting: Information-gathering update; enrollment and employment review; findings from campus community engagement

    April–May:

    • Campus Community Online Survey: Feedback from 90 respondents was incorporated into the full Campus Community Engagement Report

    April:

    • Campus Community Open House: 137 participants attended and gave feedback that will help guide the Campus Plan. Read the full open house report.

    February–March:

    • Campus site visits

    January:

    • Steering Committee kick-off meeting
    • Project Plan approval
    • Campus Plan kick-off meeting

    Campus Plan Steering Committee

    As we embark on this exciting work, a Campus Plan Steering Committee has been created to help guide the process. The Committee includes:

    • Bin Chen, Professor, Marxe School of Public and International Affairs
    • Albert Croker, Professor, Zicklin School of Business
    • Linda Essig, Provost and Senior Vice President for Academic Affairs
    • Stephen Giannotti, Vice President for Information Services and Chief Information Officer
    • Alaina Gilligo, Vice President for Operations and Administration
    • Mary Gorman, Vice President for Enrollment Management and Strategic Academic Initiatives
    • Stephen Gosnell, Department Chair, Natural Sciences, Weissman School of Arts and Sciences
    • Michael Hughes, Dean and Chief Librarian of the William and Anita Newman Library
    • Art King, Vice President for Student Affairs and Dean of Students
    • Lawrence Manganello, Associate Vice President of Facilities and Operations
    • Jennifer Mangels, Interim Dean, Weissman School of Arts and Sciences
    • Samuel Ofosu, President, Graduate Student Assembly
    • Christian Perez, President, Undergraduate Student Government
    • Sherry Ryan, Dean, Marxe School of Public and International Affairs
    • Bruce W. Weber, Willem Kooyker Dean, Zicklin School of Business
    • S. David Wu, President
